Concept visualization of the Aqua Pure sterile IV campus
Sheikhupura, Punjab · 31.457280, 74.301440

Two master plans.
One sterile strategy.

A coordinated proposal for a PIC/S-compliant IV-fluid campus built around ISPM all-in-one blow–fill technology, terminal sterilization and automated end-of-line inspection.

195,050sq ft usable plot
2proposal pathways
PE 009-17PIC/S design basis
30%proposal maturity
Executive proposition

A resilient platform for sterile IV growth

This proposal advances the available vendor layouts into a coordinated 30% engineering concept. Every unverified site, product and utility input is carried as an allowance or hold point. It is suitable for investment approval, design development and vendor alignment—not construction release.

Master planning

D3 full build-out or D4 phased entry

D3 maximizes capacity with two production trains. D4 reduces initial capital while preserving common infrastructure and physical interfaces for expansion.

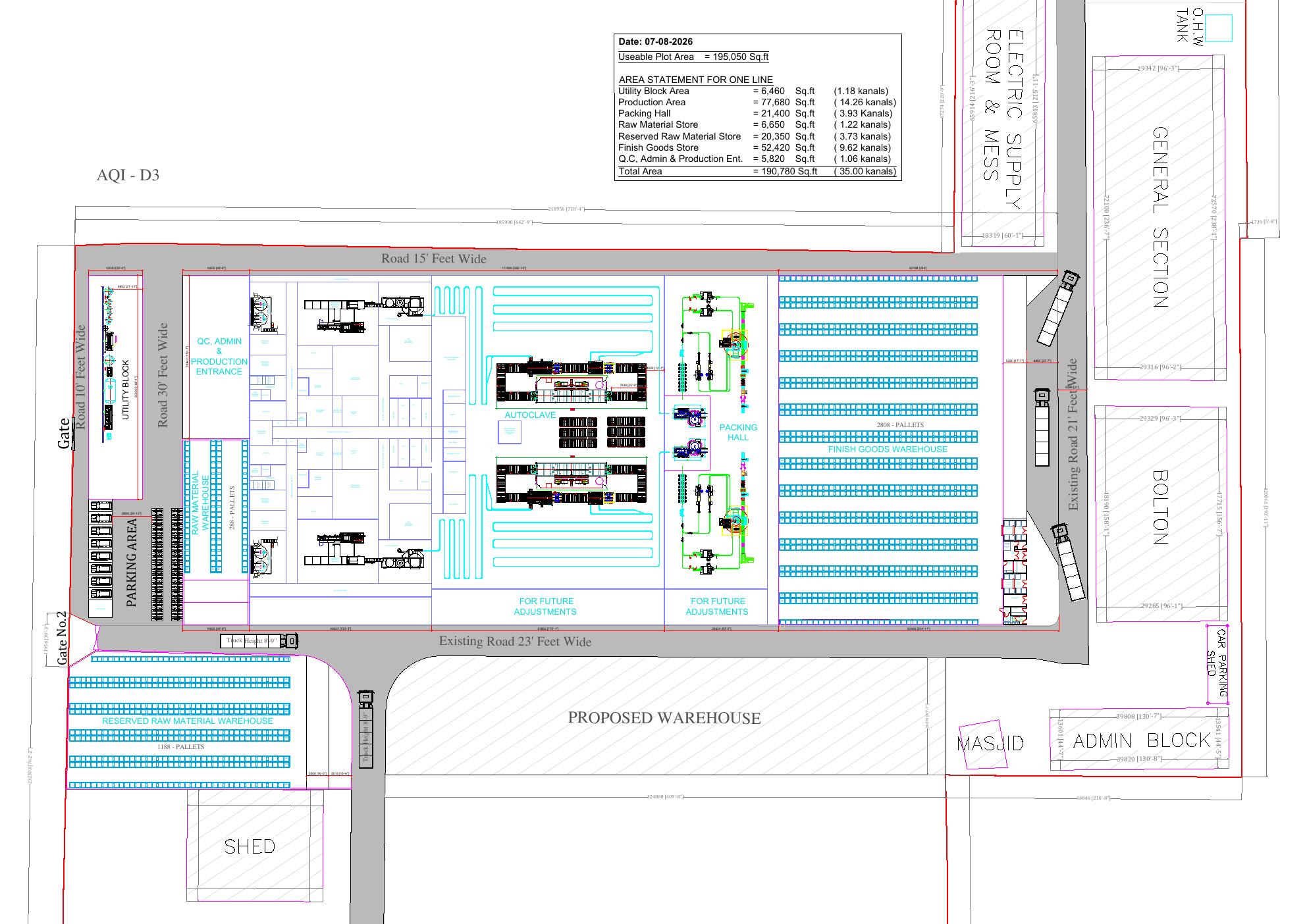

D3 proposed master plan
D3

Full two-line campus

190,780 sq ft · 35.00 kanals

  • 77,680 sq ft production
  • 21,400 sq ft packing
  • 52,420 sq ft finished goods
  • Two-line utility duty with justified standby

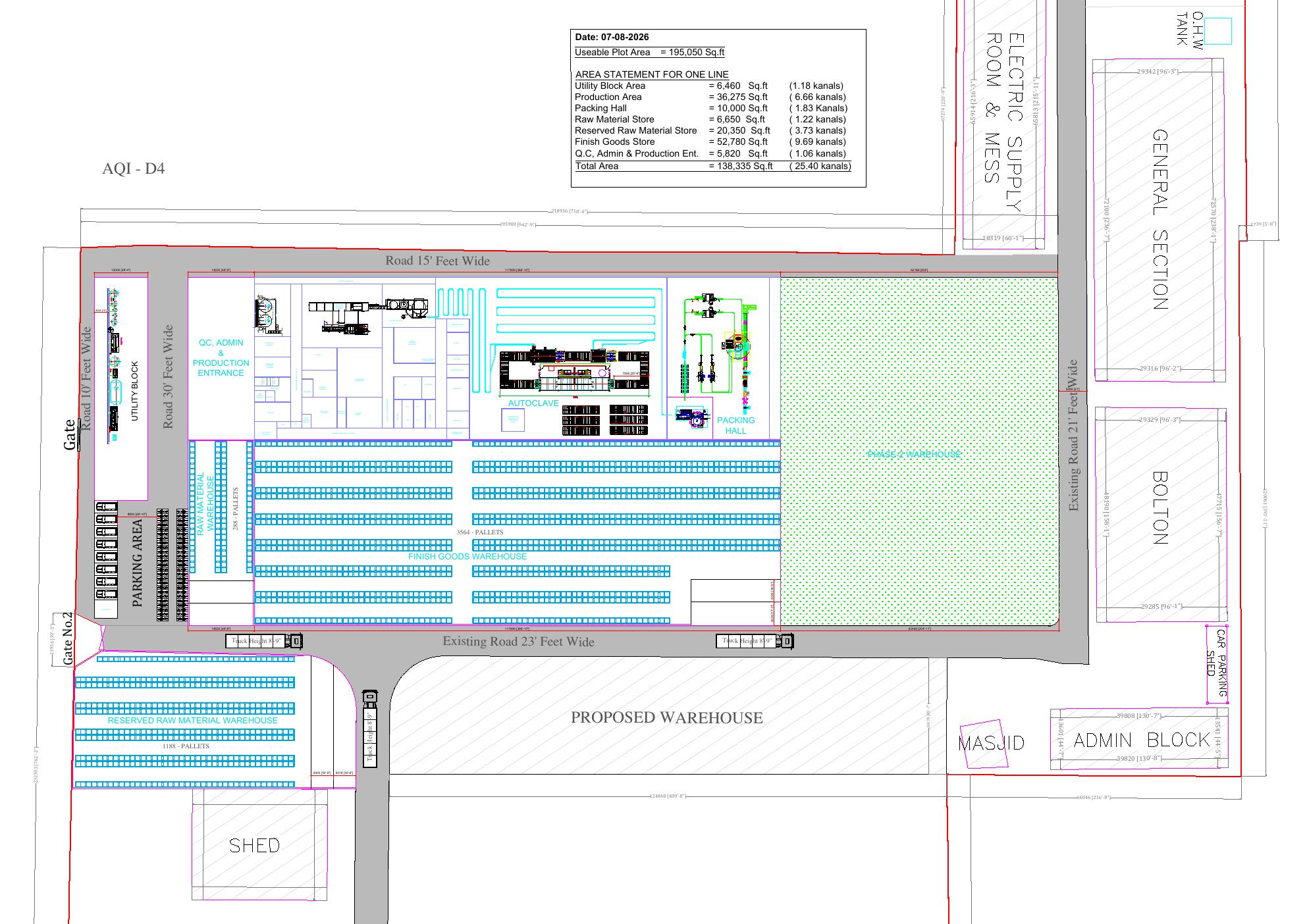

D4 proposed master plan
D4

Phased capital pathway

138,335 sq ft · 25.40 kanals

  • 36,275 sq ft production
  • 10,000 sq ft packing
  • 52,780 sq ft finished goods
  • Expansion-ready utility and tie-in corridors
ISPM all-in-one technology

Blow. Fill. Seal. Inspect.

The container is formed, filled and hermetically sealed within one automated machine cycle. The design minimizes operator intervention and treats the critical zone, sterile product path, polymer handling, interventions and environmental monitoring as one contamination-control system.

01Resin + raw materials
02Compounding
03Sterile filtration
04ISPM all-in-one blow–fill
05Terminal sterilization
06Visual inspection
07Automated packing
08Finished-goods quarantine

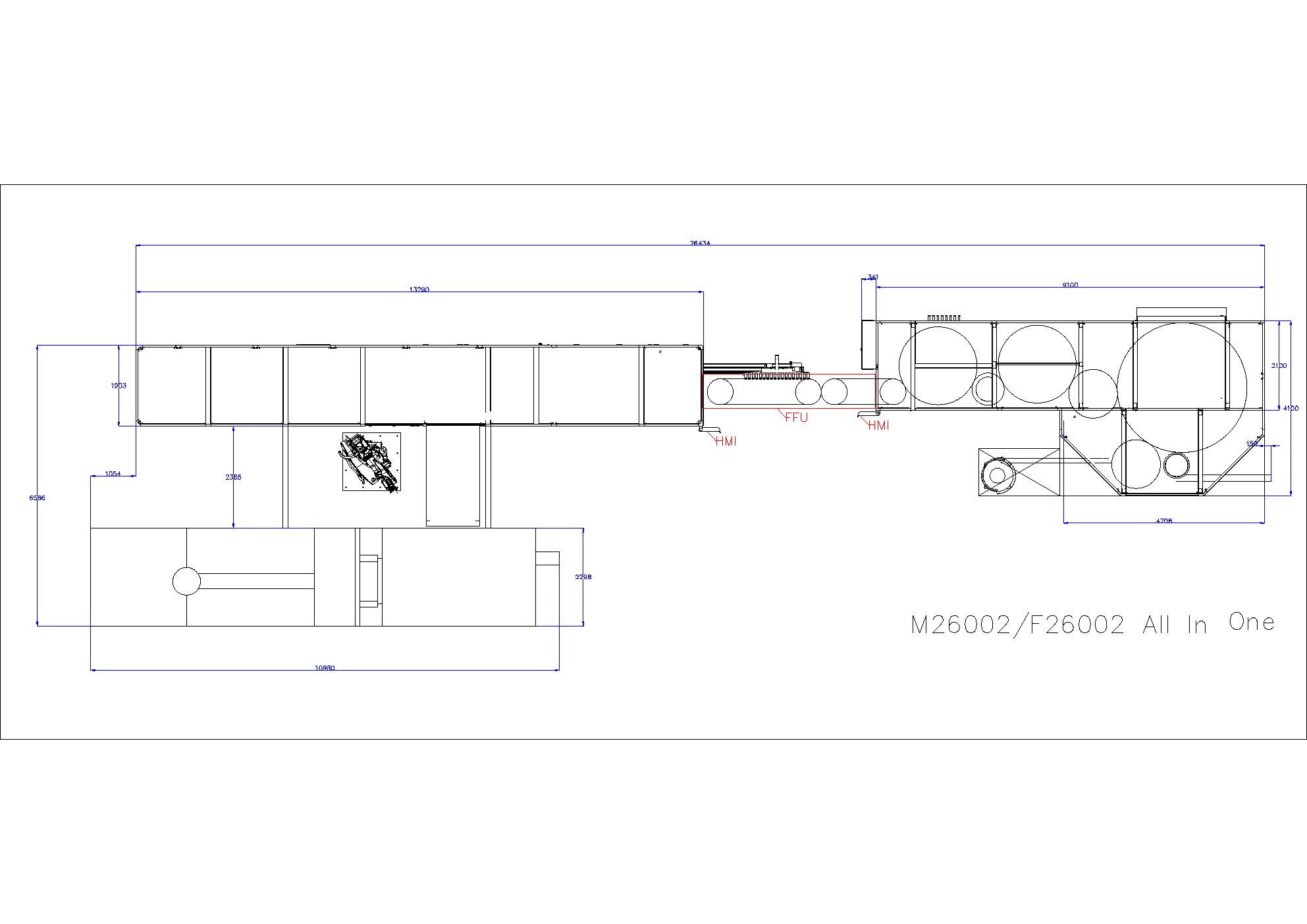

ISPM all-in-one blow fill equipment layout

Design principles

  • Grade A critical processing environment, defined by CCS and machine barrier design.
  • Sterile bulk connection, sterilizing filtration, integrity testing and closed transfer.
  • Qualified sterile air, extrusion control, mold protection and automated rejects.
  • Intervention taxonomy, line clearance, batch genealogy and audit-trailed recipe control.
  • Terminal sterilization cycle development and parametric/biological validation strategy.
  • 100% inspection, container-closure integrity and automated secondary packing.
Vendor name and model are carried as “ISPM all-in-one blow–fill” per client direction. Final performance, fill range, polymer, sterility boundary and utility values require the approved vendor URS and GA.
Preliminary engineering

P&IDs, HVAC, utilities and power

These schedules define the control intent and proposal allowances required to progress detailed design. Values are deliberately presented as design ranges until batch schedules and vendor data are frozen.

Process P&ID system architecture

SystemPreliminary flow pathCritical instrumentation / control
P-100 Raw/PWRaw tank → multimedia → softener → carbon → RO/EDI → PW tankConductivity, TOC, flow, pressure, temperature; hygienic recirculation
P-200 WFIPW → multi-effect distiller → 10/20 t WFI tank → hot loop → users80 °C target basis; spray device, sterile vent, return temperature and online conductivity/TOC
P-300 CompoundingWFI/API → 2 × 15 t vessels → sterile filter train → holding/fillerLoad cells, agitation, temperature, filter integrity, CIP/SIP permissives
P-400 ISPM BFSSterile bulk + polymer + sterile air → form/blow/fill/seal → dischargeGrade A critical zone, intervention logging, vacuum/air/fill controls, reject verification
P-500 CIP/SIPCIP tank → supply pump → user circuits → return/neutralizationTime, temperature, conductivity, flow and recipe endpoints
P-600 Clean utilitiesClean steam / oil-free air / nitrogen as required → ring mains → usersQuality monitoring, sterile filtration, condensate and dew-point controls

HVAC zoning and contamination control

ZoneFunctionClassification basisControl intent
ACritical exposed sterile zone within BFSISO 5 / Grade AUnidirectional protection; continuous particle monitoring
BBackground where required by CCSGrade BTerminal HEPA, qualified recovery, pressure alarm
CCompounding, preparation, clean supportGrade CDedicated AHU; 10–15 Pa cascade basis
DSterilizer loading/unloading and controlled corridorsGrade D / risk-basedSegregated airlocks; temperature/RH control
NPacking, warehouse, utilitiesControlled non-classifiedProduct/storage conditions; dust and heat extraction

Utility balance — proposal ranges

UtilityD3 allowanceD4 allowanceQualification / hold point
PW/WFI peakD3: 25–35 m³/hD4: 14–20 m³/h±30% proposal allowance; confirm batch schedule
WFI storage20 t duty + expansion/standby10 t initial; reserve 20 tFinal by simultaneous-use and turnover study
Clean steam3,000–4,500 kg/h1,800–2,800 kg/hSterilizer/SIP diversity required
Plant steam6,000–9,000 kg/h3,500–5,500 kg/hIncludes process/HVAC allowance
Compressed air2,500–3,500 Nm³/h1,500–2,200 Nm³/hOil-free; 7 bar; N+1 compressor philosophy
Cooling demand2.5–3.5 MW1.4–2.2 MWVendor and climatic loads pending
Electrical maximum demand4.5–6.0 MVA2.8–4.0 MVAIncludes 20% growth; diversity preliminary
Fire waterAuthority/hydraulic calculationAuthority/hydraulic calculationTank/pumps after commodity and sprinkler study

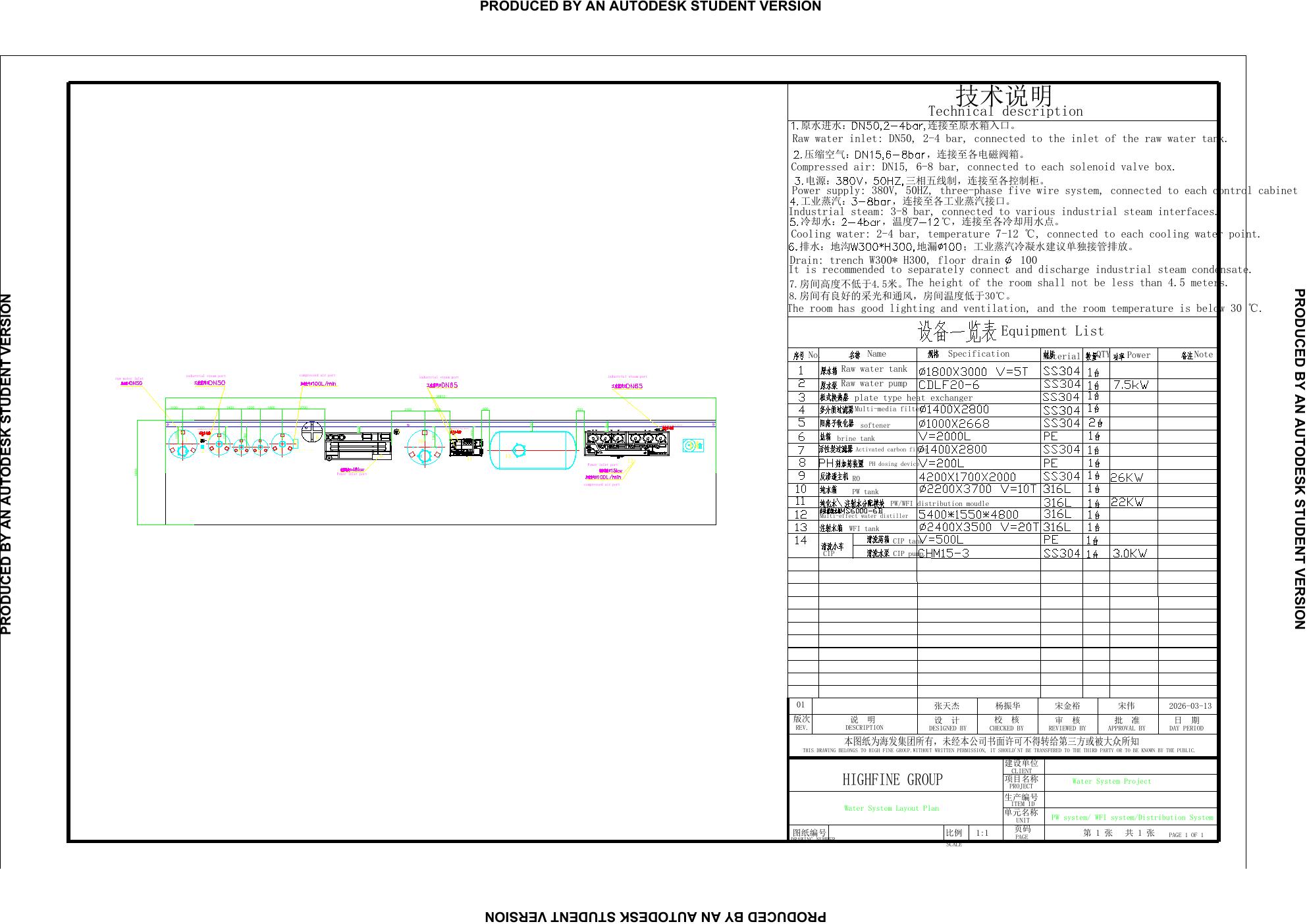

PW and WFI water system concept layout
PW / WFI architecturePretreatment → PW → multi-effect WFI → hygienic storage and recirculation

Electrical connected-load basis

Load groupD3 kWD4 kWSupply philosophy
Process/BFS/packing1,8501,050Normal + selected UPS controls
HVAC/chillers2,2001,350Emergency only for critical ventilation
Water/steam/utilities950620Sequential restart and essential standby
Warehouse/admin/ELV420350Life safety and IT separated
Growth allowance1,080730D3 20%; D4 expansion interfaces
Utility grid
11/33 kV — confirm
MV switchgear
metering + protection
N+1 transformers
segregated buses
Main LV boards
normal / essential
MCCs · UPS · BMS
selective coordination
Standby generators → essential bus · UPS → GxP controls / EMS / data · life safety → independent protected circuits
PIC/S compliance

Validation is designed in—not added later

Pakistan adopted PIC/S GMP guidance through S.R.O. 1587(I)/2025. The facility strategy is aligned with PE 009-17, revised Annex 1, Annex 11 and Annex 15, supported by ICH Q9 quality risk management.

1

Quality planning

VMP, CCS, QRM plan, system inventory, criticality and data-integrity assessments

2

Requirements/design

URS, DQ, GMP reviews, HAZOP, cleanroom concept, P&ID and software design review

3

Vendor assurance

FAT, supplier audits, material/weld records, calibration, software tests and traceability

4

Commissioning

SAT, loop checks, balancing, functional tests, passivation, cleaning and turnover dossiers

5

Qualification

IQ/OQ/PQ: HVAC, PW/WFI, clean steam, gases, sterilizers, BFS, inspection and packaging

6

Process readiness

APS/media fills as applicable, sterilization, cleaning, water PQ, EM qualification and hold times

7

Continued verification

CPV, APR/PQR, EM trending, utility review, requalification and change control

CCSIntegrated contamination-control strategy
QRMScience- and risk-based decisions
APSAseptic process simulation where applicable
EMViable/non-viable monitoring and trending
CSVData integrity and computerized systems
CPVContinued process verification
Budget BOQ framework

Investment structure before false precision

A reliable monetary BOQ requires local rates, vendor quotations, quantities and the selected option. At proposal stage, the correct control is a structured cost model with class-4 contingency—not invented prices.

PkgCost packageTypical shareIncluded basis / exclusion
APreliminaries, design, permits, QA8–12%Surveys, detailed design, authority fees, project controls
BCivil, structure, envelope15–20%Ground improvement excluded until geotechnical study
CGMP architecture/cleanrooms10–14%Panels, doors, ceilings, finishes and pass-throughs
DProcess equipment and packing24–32%ISPM line, compounding, sterilization, inspection, packing
EWater/clean utilities/process piping12–17%PW/WFI, clean steam, air, CIP/SIP and hygienic piping
FHVAC/BMS/EMS12–16%AHUs, chillers, ducts, HEPA, controls and monitoring
GElectrical/ELV/backup power8–12%Transformers, generators, UPS, panels, cables, fire alarm and IT
HValidation/start-up/spares5–8%C&Q, CSV, consumables, training, initial spares
IRisk contingency15–25%Class-4 estimate range until scope and site data mature
Recommended commercial issue: D3 and D4 priced independently in PKR and USD after receiving budget quotations from ISPM, sterilizer, water-system, HVAC/cleanroom and power-generation vendors. Accuracy target at this maturity: approximately −30% / +50%, tightened progressively through design freeze.
Decision gates

What must be proven next

The proposal is engineered to advance without pretending unknowns are facts.

01

Site truth

Boundary/topographic survey, geotechnical investigation, groundwater and flood/drainage assessment.

02

Product truth

Approved product matrix, batches, fill volumes, polymers, sterilization cycles and annual demand.

03

Utility truth

Raw-water analysis, grid capacity/fault level, fuel, sewer, emissions and authority constraints.

04

Vendor truth

URS, GA, maintenance clearances, heat rejection, clean utilities, automation and FAT protocols.

Regulatory reference set

PIC/S GMP Guide PE 009-17 and Annexes ↗Revised Annex 1 entry into force ↗DRAP S.R.O. 1587(I)/2025 adoption record ↗DRAP consolidated GMP guidance ↗
